DAY 1 Start 11h00 Finish 17h00
STEP 1

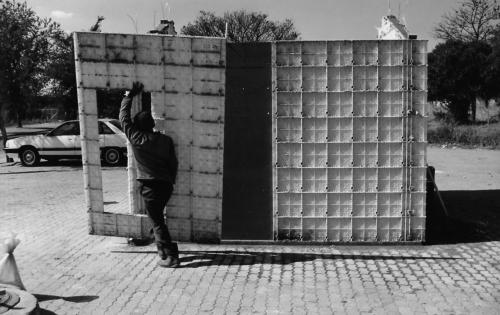

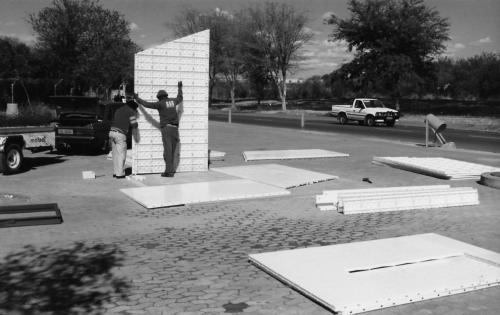

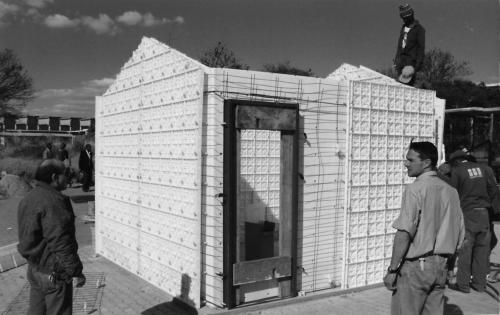

• moladi formwork is delivered to site. Area = 74m² Mass = 550kg Volume = 4m³ • moladi formwork panels are assembled by unskilled labourers to form the mould panels of the desired house plan.
STEP 2

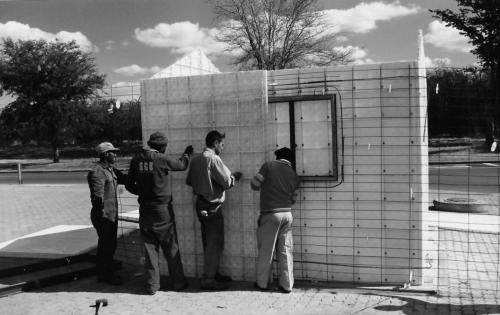

• Internal formwork panels are erected. • Window frames and block-outs are positioned within the wall cavity. • Reinforcing bars are positioned within the cavity to engineer specifications

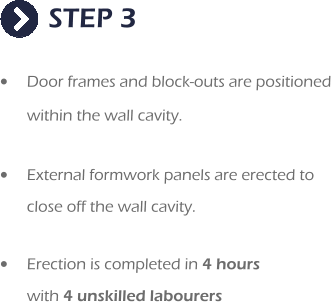

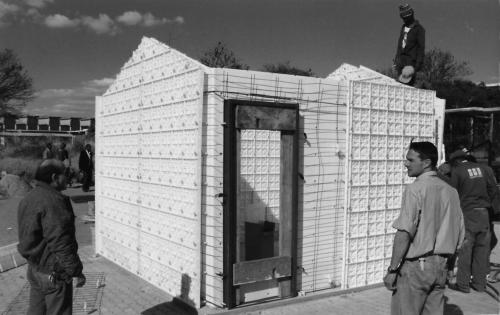

STEP 3 •	Door frames and block-outs are positioned within the wall cavity.  •	External formwork panels are erected to  close off the wall cavity.  •	Erection is completed in 4 hours  with 4 unskilled labourers
STEP 4

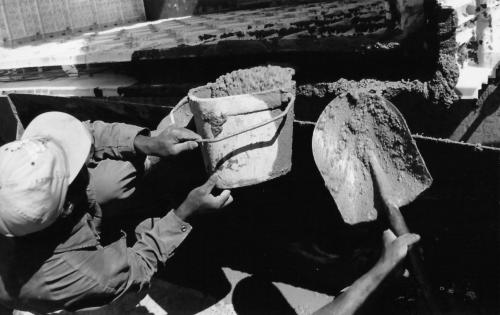

• The wall cavity is filled with 4m³ of moladi aerated mortar by unskilled labourers. • The pour is completed in 2 hours with 4 unskilled labourers.
DAY 2 Start 07h00 Finish 17h00 STEP 5
• moladi formwork panels are removed. • moladi formwork panels are completely removed in 2 hours with 4 unskilled labourers.
STEP 6

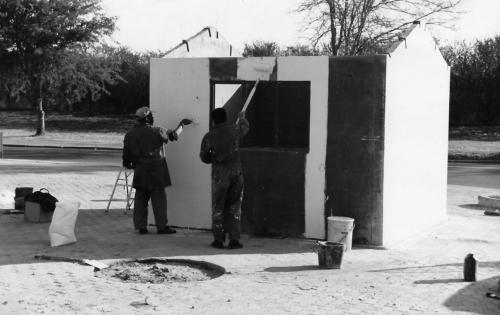

• Immediately after the formwork panels are removed, the walls are painted with cementitious water based paint. • Oil or acrylic based paints can be applied after the walls have cured, or in 28 days.
STEP 7
• The engineer certified roof is installed. • The windows and doors are installed. • Final finishing’s, such as sanitary ware and lighting are completed. • The structure is now ready for occupation.
ADDRESS PO Box 16553 Emerald Hill Port Elizabeth South Africa 6011
CONTACT Mail: click here Phone: +27 413792600 Fax: +27 865026930
Copyright reserved © Terms of use apply

PROCESS

HOW IT WORKS
NAVIGATION
SOCIAL
DAY 1 Start 11h00 Finish 17h00
STEP 1
• moladi formwork is delivered to site. Area = 74m² Mass = 550kg Volume = 4m³ • moladi formwork panels are assembled by unskilled labourers to form the mould panels of the desired house plan.
STEP 2 •	Internal formwork panels are erected.   •	Window frames and block-outs are positioned within the wall cavity.  •	Reinforcing bars are positioned within the cavity to engineer specifications STEP 3 •	Door frames and block-outs are positioned within the wall cavity.  •	External formwork panels are erected to  close off the wall cavity.  •	Erection is completed in 4 hours  with 4 unskilled labourers STEP 4
• The wall cavity is filled with 4m³ of moladi aerated mortar by unskilled labourers. • The pour is completed in 2 hours with 4 unskilled labourers.
DAY 2 Start 07h00 Finish 17h00 STEP 5
• moladi formwork panels are removed. • moladi formwork panels are completely removed in 2 hours with 4 unskilled labourers.
STEP 6
• Immediately after the formwork panels are removed, the walls are painted with cementitious water based paint. • Oil or acrylic based paints can be applied after the walls have cured, or in 28 days.
STEP 7
• The engineer certified roof is installed. • The windows and doors are installed. • Final finishing’s, such as sanitary ware and lighting are completed. • The structure is now ready for occupation.
ADDRESS PO Box 16553 Emerald Hill Port Elizabeth South Africa 6011
CONTACT Mail: click here Phone: +27 413792600 Fax: +27 865026930
Copyright reserved © Terms of use apply
NAVIGATION
SOCIAL
moladi logo
moladi logo
moladi building system
